2025 Local Roads Program - Curb & Gutter

The 2025 Local Roads Program includes construction on approximately 27.3 miles of local roadways in Meridian Township. This work is funded by the Local Roads Millage, which was passed by Meridian Township voters in August of 2019. The work ranges from preventative maintenance (to preserve pavement that is still in good condition) to full road reconstruction:

  • Asphalt Rejuvenator Spray Treatment – 14.59 miles
  • Crack Fill – 6.69 miles
  • Reconstruction of Roads without Curb and Gutter – 2.68 miles
  • Reconstruction of Roads with Curb and Gutter – 3.02 miles
  • Asphalt Stabilization – 0.32 miles
Documents

Lac Du Mont Drive Update (8/11/25)

8/12: Weather permitting, the Township’s contractor will pave the first layer of asphalt on Phase II. If time and weather allow, the contractor will also start paving the second and final layer on one half of Lac Du Mont Drive.

On days when the contractor is paving, access to your normal parking lot may be impacted for 30-90 minutes. You will be able to drive north and south down Lac Du Mont on the side that is not currently being paved. However, if the contractor has just paved in front of your parking lot entrances, the asphalt will need 30-90 minutes to cool and compact before traffic can enter. Please park in the nearest open parking lot during these times. Expect delays when traveling on Lac Du Mont Drive during paving days. The half of the road that is not paved will also be used to transport asphalt to the site. You may have to wait behind semis for short periods.

8/13: Weather permitting, the Township’s contractor will finishing paving the second and final layer of asphalt on Lac Du Mont Drive.

8/14: If paving cannot be completed on 8/12 and 8/13, this is a contingency paving date to finish paving.

Manholes will likely be raised in September as the subcontractor has other projects that need to be completed prior to bus routes resuming at the start of the K-12 school year.


Lac Du Mont Drive Update (7/24/25)

The cement stabilization treatment has been completed on Phase I of Lac Du Mont Drive.

7/25: Phase I will be reopened between 4:00 pm - 5:00 pm. Please DO NOT drive on Phase I until it is reopened. This ensures that the cement stabilization treatment is not compromised while it cures.

7/28: Weather permitting, the Township’s paving contractor will pave the first layer of asphalt on Phase I.

On days when the contractor is paving, access to your normal parking lot may be impacted for 30-90 minutes. You will be able to drive north and south down Lac Du Mont on the side that is not currently being paved. However, if the contractor has just paved in front of your parking lot entrances, the asphalt will need 30-90 minutes to cool and compact before traffic can enter. Please park in the nearest open parking lot during these times. Expect delays when traveling on Lac Du Mont Drive during paving days. The half of the road that is not paved will also be used to transport asphalt to the site. You may have to wait behind semis for short periods.

The following is the current weather-dependent schedule for Phase II:

  • 8/4: Manholes will be lowered with Lac Du Mont Drive open to local traffic.
  • 8/5: Mill off the top 4.5 inches of existing asphalt with Lac Du Mont Drive open to local traffic.
  • 8/6: Crush the remaining existing asphalt in place with Lac Du Mont Drive open to local traffic.
  • 8/7-8/9: Phase II of Lac Du Mont Drive closed to ALL traffic except for emergency first responders. To assist residents during the closure period, golf carts will be available for shuttle services from 7:00 am to 7:00 pm. These golf carts will transport you to and from your home, vehicle, or the nearest CATA stop on Bois Isle Drive as needed. Typically, the golf carts will be stationed at the intersection where Phase I and Phase II meet, near 2047 Lac Du Mont Drive. You can request a ride by calling the golf cart operators at 773.720.2715.
  •  8/7-8/8: Cement stabilization treatment is performed.
  • 8/9: No construction activities will occur on this date. This date is to allow for one full day of cure time before reopening the Phase II portion of Lac Du Mont Drive to local traffic only. Phase II of Lac Du Mont Drive will be reopened to local traffic late in the day on Saturday, August 9.
  • 8/12: The Township’s paving contractor will pave the first layer of asphalt on Phase II.
  • 8/13 and/or 8/14: The Township’s paving contractor will pave the second and final layer on all of Lac Du Mont Drive. Paving will occur a half width of the roadway so the other half of the road can be used to maintain traffic.




UPDATE (7/8/25 7:30 pm)

On July 8, a virtual informational meeting was held to provide more information about the project and to answer any questions residents had. A recording of that meeting can be found below:

Lac Du Mont Drive Reconstruction Informational Meeting Recording - July 8, 2025

A copy of the presentation from the meeting can also be found below:

Lac Du Mont Drive Meeting Presentation


Lac Du Mont Drive Update (7/8/25)

At this time, the Township only anticipates closing Lac Du Mont Drive for three days per phase. The Phase I portion of Lac Du Mont Drive will be closed from Wednesday, July 23 through Friday, July 25.

A map of Phase I and Phase II of construction can be found below:

Lac Du Mont Construction Phases Map

To assist residents during the closure periods, golf carts will be available for shuttle services from Monday to Saturday, between 7:00 am and 7:00 pm. These golf carts will transport you to and from your home, vehicle, or the nearest CATA stop on Bois Isle Drive as needed. Typically, the golf carts will be stationed at the intersection where Phase I and Phase II meet, near 2047 Lac Du Mont Drive. You can request a ride by calling the golf cart operators at 773.720.2715.

The following is the tentative, weather-dependent construction schedule for Phase I of the Lac Du Mont Drive reconstruction project:

  • Week of July 14: Lower manhole structures located in Lac Du Mont Drive, with Lac Du Mont Drive open to local traffic.
  • Monday (7/21): Mill off the top 4.5" of existing asphalt with Lac Du Mont Drive open to local traffic.
  • Tuesday (7/22): Crush the remaining existing asphalt in place with Lac Du Mont Drive open to local traffic.
  • Wednesday - Friday (7/23-7/25): Phase I of Lac Du Mont Drive closed to ALL traffic except for emergency first responders.
  • Wednesday - Thursday (7/23-7/24): Cement stabilization treatment is performed.
  • Friday (7/25): No construction activities will occur on this date. This date is to allow for 1 full day of cure time before reopening the Phase I portion of Lac Du Mont Drive to local traffic only. Phase I of Lac Du Mont Drive will be reopened to local traffic late in the day on Friday, July 25.
  • Monday (7/28): Weather dependent, the first layer of asphalt will be paved on the Phase I portion of Lac Du Mont Drive. Paving will be completed on one half of the roadway at a time to maintain local traffic on the other half of the roadway.

The Township will announce a tentative, weather-dependent construction schedule for Phase II of the Lac Du Mont Drive reconstruction project as soon as it has been confirmed.

We apologize in advance for any inconvenience caused during construction, and we truly appreciate your patience and understanding while we work to improve your neighborhood and our entire community.


Lac Du Mont Drive Update (6/23/25)

Curb and gutter spot repairs on Lac Du Mont Drive will be completed the week of June 23. The asphalt construction portion of the project is scheduled to begin in mid-July and will be completed by mid-to-late August.

Due to the complexity of this project, residents are highly encouraged to attend a virtual informational meeting on Tuesday, July 8 from 6:00 pm to 7:00 pm.

Meridian Township staff members and the Township's engineering firm for this project will be in attendance to present the information and answer any questions residents may have. A link to the meeting can be found below:

July 8, 2025 Lac Du Mont Informational Meeting Link

Meeting ID: 262 215 067 502 8Passcode: TV2mU9De

Lac Du Mont Drive Meeting Presentation

A recording of the meeting will be provided afterwards for anyone who was unable to attend. Questions regarding this project or the upcoming meeting can be directed to Dan Bomzer, PE at localroads@meridian.mi.us or by calling 269.926.4552.

A copy of the notice sent to residents can also be found below:

Lac Du Mont Construction Flyer and Notice - June 23 Update


Tacoma Hills Update for Roads with Curb and Gutter (6/6/25)
  • For roads with curb and gutter, weather permitting, the second and final layer of asphalt is scheduled to be paved on 6/9.
  • These roads will be closed to traffic for approximately 1 hour once paved to allow the asphalt to cool. Please park on adjacent roads and walk to and from your home.
  • For roads with curb and gutter, the manholes will be raised the week of 6/16 once the asphalt has fully cured.
  • Concrete collars will be poured around the manholes when they are raised. Cones will be left around the concrete collars while the concrete cures.
  • Please do NOT drive over the concrete collars around manholes under the cones have been collected.

Curb and gutter spot repairs will begin the week of June 9. The Township, in partnership with CATA, will also be installing new ADA accessible bus stop concrete pads as part of the Lac Du Mont road resurfacing project.

Lowering manholes, milling (i.e. removal of existing asphalt), crushing of remaining asphalt, cement stabilization, and paving work on Lac Du Mont Drive is currently expected to begin on Monday, July 14.

Please note that CATA bus routes 22 and 23 will be detoured to Bois Isle Drive on or before July 14. The Township is confirming the exact date with CATA and will publish the date once it has been confirmed.

Users of Lac Du Mont Drive are encouraged to review the construction notice for this project by clicking here.


Lac Du Mont Drive Update (6/2/25)

Curb and gutter spot repairs will begin the week of June 9.

Milling (i.e. removal of existing asphalt), cement stabilization, and paving work on Lac Du Mont Drive is currently expected to begin shortly after the 4th of July holiday.

Users of Lac Du Mont Drive are encouraged to review the construction notice for this project by clicking here.


Tacoma Hills Update (5/30/25)
  • For roads that do NOT have curb and gutter, the Township’s contractor continues to work on any necessary ditch clean out and culvert replacement work.
  • All ditch roads have had the existing asphalt crushed with the exception of Tacoma Blvd. Tacoma Blvd will likely be crushed the week of June 9 once the other roads have been paved.
  • The Township’s contractor will completing the final milling (i.e. removing existing asphalt) from roads that have curb and gutter on May 30.
  • The milling and crushing work typically moves past a given driveway in approximately 10 minutes, after which there is a rough gravel surface that you can drive on. The milling, crushing and paving work will be completed one lane at a time, thus the streets will be usable on at least one side at almost all times. An entire street is normally milled in one (1) day. Once the milling is finished, the first layer of new asphalt will be placed within 10 days.
  • Weather dependent, the Township’s contractor will be paving roads on May 31 and June 2-6. The roads with curb and gutter are likely to be paved first.
  • Additional paving dates will be announced when they are scheduled.

Tacoma Hills Update (5/19/25)
  • All storm sewer spot repairs have been completed.
  • All curb and gutter spot repairs have been completed.
  • For roads that do NOT have curb and gutter, the Township’s contractor continues to work on any necessary ditch clean out and culvert replacement work.
  • Weather dependent, the Township’s contractor will be lowering manholes on curb and gutter roads on May 22 and 23.
  • Weather dependent, the Township’s contractor is scheduled to crush the existing asphalt in place on roads that do NOT have curb and gutter on May 28.
  • Weather dependent, the Township’s contractor will be milling (i.e. removing existing asphalt) from roads that have curb and gutter on May 29 and 30.
  • The milling and crushing work typically moves past a given driveway in approximately 10 minutes, after which there is a rough gravel surface that you can drive on. The milling, crushing, and paving work will be completed one lane at a time, thus the streets will be usable on at least one side at almost all times. An entire street is normally milled in one day. Once the milling is finished, the first layer of new asphalt will be placed within 10 days.
  • Weather dependent, the Township’s contractor will be paving roads from June 2-6. The roads with curb and gutter are likely to be paved first.
  • Additional paving dates will be announced when they are scheduled.

Tacoma Hills Update (5/8/25)
  • Weather dependent, the Township’s contractor will close Tacoma Boulevard between Lagoon Drive and Pawnee Trail beginning Monday, May 12, to repair a storm drain under Tacoma Boulevard. Weather dependent, this hard closure is anticipated to be in place for two to three days. While this closure is in place, motorists should use Tomahawk Road, Manitou Drive, and Oneida Drive as a detour route. This is the final storm sewer spot repair that needs to be completed.
  • Curb and gutter spot repairs are being made in Tacoma Hills. The work is anticipated to be completed by Friday, May 16.
  • Weather dependent, Township’s contractor will begin ditch clean out work, culvert replacements, and lowering manholes on Monday, May 12. This work will continue into late May.
  • Weather dependent, the Township’s contractor will begin crushing and milling (removing) existing asphalt.

Paving dates will be announced once they are confirmed.


Tacoma Hills Update (4/8/25)

Consumers Energy is currently finishing up their replacement of natural gas mains and service lines in Tacoma Hills prior to road work beginning. We currently estimate that Consumers Energy will complete their work by Friday, April 25.

The Township hopes to confirm a weather-dependent schedule for completing spot repairs to storm drains by Monday, April 14. This weather-dependent schedule will be published once it has been confirmed. The Township currently anticipates the storm drain repairs occurring between mid-April and mid-May.

Damaged or settled sections of curb and gutter that are preventing proper road drainage will be replaced prior to the beginning of paving work. The Township does not replace curb and gutter for aesthetic purposes. The Township currently anticipates that curb and gutter spot repairs will occur between April 21 and May 16.

If the curb and gutter across your driveway is removed, there will be a period when you have to drive over your driveway without the curb and gutter. Once the concrete is scheduled to be poured, Lopez Concrete Construction, LLC will communicate with property owners to ensure their vehicles are moved prior to pouring.

The concrete will then take five to seven days to cure. If concrete is poured across your driveway frontage, you will need to park in the street during this time.

The Township’s paving contractor will begin work once the storm drain spot repair and curb and gutter spot repair work has been completed, which will likely be in mid-to-late May.

We apologize for any inconvenience caused during construction, and we truly appreciate your patience and understanding while we work to improve your neighborhood and our community.


Everett Farms Update (4/3/25)

Lopez Concrete Construction, LLC is currently finishing up the curb and gutter spot repairs and ADA sidewalk ramp upgrades in Everett Farms prior to paving work beginning.

If the curb and gutter across your driveway is removed, there will be a period when you have to drive over your driveway without the curb and gutter. Once the concrete is scheduled to be poured, Lopez Concrete Construction, LLC will communicate with property owners to ensure their vehicles are moved prior to pouring.

The concrete will then take five to seven days to cure. If concrete is poured across your driveway frontage, you will need to park in the street during this time.

Timeline for milling and paving of Everett Farms:

  • Week of April 14 | Weather dependent, manholes will be lowered to prepare resurfacing of the roads.
  • Monday, April 21 | Weather dependent, milling (i.e. removal of existing asphalt) will begin.
  • Thursday, April 24 | Weather dependent, the Township’s paving contractor will begin paving the first of two layers of asphalt.

Additional paving dates will be announced once they are confirmed.


UPDATE (3/24/25)

As part of the 2025 Local Roads Program, the Township's concrete contractor (Lopez Concrete Construction, LLC), will begin removing curb and gutter and sidewalk ramps on Tuesday, March 25.

We anticipate being able to start pouring concrete late this week or the week of March 31. However, when we can begin pouring concrete is dependent upon temperatures.

If the curb and gutter across your driveway is removed, there will be a period when you have to drive over your driveway without the curb and gutter. Once the concrete is scheduled to be poured, Lopez Concrete Construction, LLC will communicate with property owners to ensure their vehicles are moved prior to pouring. The concrete will then take five to seven days to cure. If concrete is poured across your driveway frontage, you will need to park in the street during this time.

Before paving work begins, damaged or settled sections of the curb and cutter (that are preventing proper road drainage) will be replaced. The Township will not add additional curb and gutter for replacement, and the Township does not replace curb and gutter for aesthetic purposes.

Additionally, any sidewalks crossing the listed streets on that map below will be upgraded according to the current Americans with Disabilities Act (ADA) requirements, as necessary. This generally includes lowering existing sidewalk ramps to reduce the ramp slopes, realigning existing ramps for better directional guidance at the crossing, or adding new ramps to provide an accessible crossing.

We apologize for any inconvenience caused during construction, and we truly appreciate your patience and understanding while we work to improve your neighborhood and our community.


UPDATE (2/13/25)

Consumers Energy will begin natural gas utility work in mid-to-late February. This work is estimated to be completed between late March and mid-April.

Consumers Energy will replace a natural gas main and gas service lines that serve homes in the Tacoma Hills neighborhood. If the service line to your house needs to be replaced, Consumers Energy will contact you directly to schedule this work. Gas service to your home will need to be shut off for a brief period to complete the replacement. Scheduling with Consumers Energy in a timely manner will help keep the Local Roads Program on track.

Any questions regarding the gas upgrades should be directed to Adam Bertram with Consumers Energy at Adam.Bertram@cmsenergy.com or 517.374.2375.

This work is being performed in coordination with Meridian Township’s Local Roads Program to reduce the need to cut the newly paved roads in the future. The roads that will be resurfaced in 2025 are shown in blue on the map at the bottom of this update, and Consumers Energy will be working in the project limits shown in blue on the map.

Spot repairs to storm drains will also be performed in coordination with the 2025 road resurfacing in Tacoma Hills.

Please continue to monitor this webpage for the most current construction updates.

A PDF version of the Tacoma Hills map, as well as an embedded image of the map, can be found below:

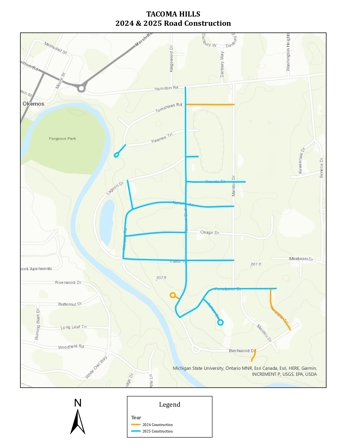

Tacoma Hills 2024 and 2025 Construction Map



For Meridian Township's road classification map, the 2019 PASER rating map, and the 2025 post-construction PASER rating map, please view the three links below:
